I Almost Lost My House Because I Skipped Building Approval. Here Is What You Must Know

Getting proper building approval in Nigeria protects your investment, prevents demolition threats, and increases your property’s long term value.
Building a house in Nigeria without proper approval is one of the most expensive mistakes I have seen property owners make. People spend millions of naira on foundations, roofing, and finishing only to receive stop work notices, heavy fines, or demolition threats. All because they skipped one critical process.
Today, development control authorities across Nigeria are getting stricter. Cities like Lagos, Abuja, Port Harcourt, Uyo, and Enugu are actively enforcing compliance. Whether you are building a bungalow, duplex, block of flats, or commercial property, ignoring building approval is a risk you simply cannot afford.
In this guide, I will guide you through everything you need to know. We will cover approval requirements, costs, government agencies, common mistakes Nigerians make, and practical steps to get your plan approved without unnecessary delays.
What Is Building Approval in Nigeria?
Building approval is the official government permission that allows you to legally construct on your land. Before construction begins, the relevant authority reviews your proposed design to confirm it meets specific standards.
These standards cover:
- Zoning and land use rules
- Structural safety requirements
- Setback regulations
- Drainage and environmental standards
- Road alignment compliance
- Ventilation and plot coverage rules
Without this approval, your building is considered an illegal structure regardless of how well it is constructed.
Why Building Approval Matters More Than Most Nigerians Think
Many property owners believe approval is only relevant for large commercial developments. That assumption has destroyed many investments.
What building approval protects you from:
- Demolition notices and construction shutdowns
- Government fines and legal disputes
- Structural failures linked to unapproved designs
- Insurance rejections
- Difficulties selling or transferring property
- Tenant legal complications
What approval improves:
- Property market value and resale attractiveness
- Eligibility for bank loans and mortgages
- Acceptance into estates and gated developments
- Rental confidence and buyer trust
- Long term investment security
I always tell clients: an approved building is a safer investment, a stronger asset, and a much easier property to sell, rent, or mortgage when the time comes.
Government Agencies Responsible for Building Approval in Nigeria
Approval authorities differ from state to state. Knowing the right agency for your location saves time and prevents misdirected submissions.
| State | Responsible Authority |
|---|---|
| Lagos | Lagos State Physical Planning Permit Authority (LASPPPA) |
| Abuja | Federal Capital Development Authority (FCDA) |
| Rivers State | Rivers State Ministry of Urban Development |
| Akwa Ibom | Akwa Ibom State Physical Planning Board |
Most states operate through urban planning boards, physical planning authorities, or development control departments. If you are unsure, visit your state ministry responsible for lands and urban planning to confirm the right agency.
Documents Required for Building Approval in Nigeria
Incomplete document submissions are one of the biggest causes of approval delays. I always advise clients to prepare everything in a single complete package before walking into any approval authority.
Land Documents
- Certificate of Occupancy (C of O) or Deed of Assignment
- Registered survey plan
- Registered title documents
Architectural Documents
- Architectural drawings (floor plans, elevations, sections, site plan, roof plan)
- Site layout showing drainage and parking arrangement
Engineering Documents
- Structural drawings
- Foundation details and specifications
- Structural calculations
Town Planning Documents
This is where many applicants get caught off guard. Beyond architectural and structural drawings, local planning authorities all the state approval authorities require formal town planning documentation prepared and signed by a registered town planner.
Site Planning Analysis Report (SPAR)
A SPAR is a technical document prepared by a registered town planner that analyses your proposed development in relation to its immediate environment. It covers:
- Land use compatibility with surrounding developments
- Compliance with the area’s zoning designation
- Traffic and pedestrian access implications
- Setback verification against approved planning standards
- Plot coverage and open space assessment
- Parking adequacy for the proposed use
- Relationship of the development to existing infrastructure
The SPAR essentially confirms to the approval authority that your proposed building fits legally and functionally within its planning context. Without it, many authorities will not process your application.

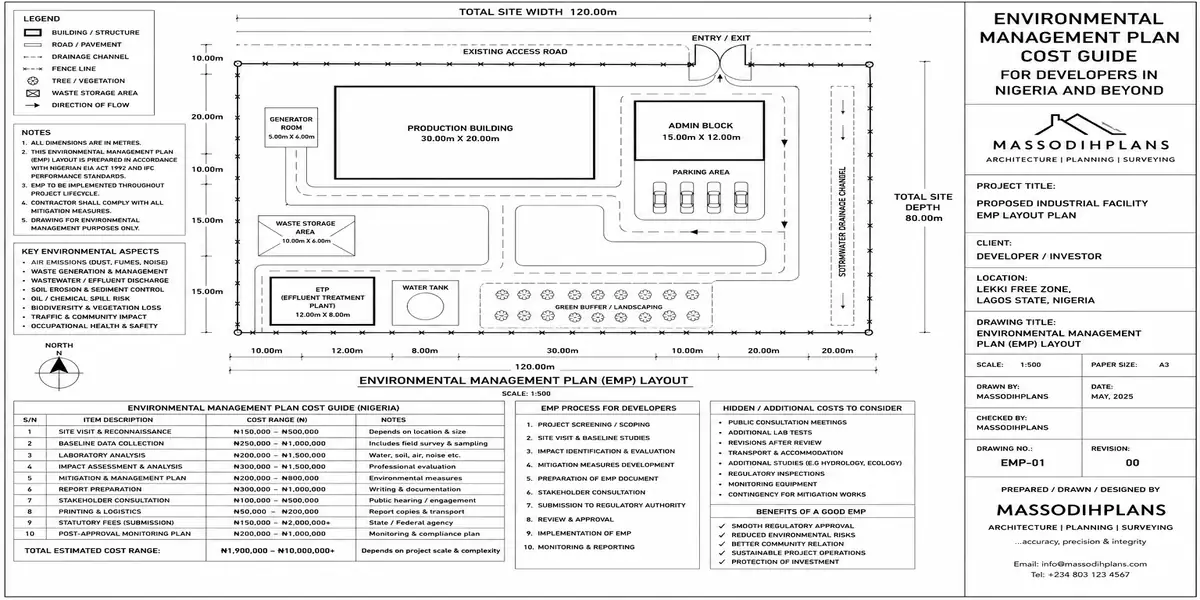

Environmental Impact Assessment Report (EIAR)
For larger developments, mixed use projects, commercial buildings, estate developments, and projects in environmentally sensitive areas, an Environmental Impact Assessment Report is required. This document is also prepared or supervised by qualified professionals and covers:
- Potential environmental effects of the proposed construction
- Soil and groundwater disturbance assessment
- Waste generation and disposal plan during construction
- Noise and air quality impacts on surrounding residents
- Drainage and flooding risk assessment
- Mitigation measures for identified environmental concerns
- Post construction environmental management plan
Even for some residential projects in flood prone zones or ecologically sensitive areas like parts of the Niger Delta, coastal Lagos, and certain areas of Akwa Ibom, an EIAR or a simplified Environmental Impact Statement may be requested before approval is granted.
Town Planner’s Report and Certification
Beyond the SPAR, some state authorities require a separate professional report and certification signed by a town planner registered with the Nigerian Institute of Town Planners (NITP). This certification confirms that:
- The design complies with applicable planning regulations
- The proposed land use is consistent with the zoning for that area
- Setbacks, plot coverage, and open space meet required standards
- The development does not violate any regional or local planning scheme
In states like Lagos, Rivers, and Akwa Ibom, submitting drawings without this professional town planning input is increasingly becoming grounds for outright rejection.
Supporting Documents
- Soil test report
- Tax clearance certificate (required in some states)
- Passport photographs of the applicant
- Completed application forms with appropriate fee receipts
Which Buildings Require Approval in Nigeria?
Almost every permanent structure requires formal approval before construction.
Residential: Bungalows, duplexes, terraces, flats, and mini estates
Commercial: Shops, offices, hotels, warehouses, and filling stations
Institutional: Schools, churches, hospitals, and factories
Even fence walls and gatehouses may require approval in urban areas across Lagos, Abuja, and Port Harcourt. Do not assume any structure is too small to need documentation.
Step By Step Building Approval Process in Nigeria
Step 1: Conduct Proper Land Verification
Before buying any land, verify:
- Government acquisition or revocation status
- Road alignment and expansion plans
- Flood risk and drainage corridor status
- Existing boundary disputes
- Zoning restrictions for your proposed use
I have seen people pour money into foundations only to discover their land falls inside a government drainage corridor or road expansion zone. Verify first, build later.
Step 2: Carry Out a Site Survey
A licensed surveyor prepares your survey plan showing land dimensions, coordinates, adjoining roads, existing structures, and site orientation. This document determines your building position, setbacks, parking layout, and drainage flow.
Step 3: Prepare Architectural Drawings
Your architect prepares floor plans, elevations, roof design, site layout, septic layout, and drainage proposal. This stage is critical. Poorly prepared drawings are one of the most common causes of approval rejection.
Step 4: Structural Design Preparation
Your structural engineer designs the foundation system, columns, beams, slabs, and reinforcement specifications. In areas like parts of Port Harcourt and coastal regions with difficult soil conditions, this stage directly impacts construction safety and cost.
Step 5: Submit to the Approval Authority
Your consultant submits all drawings, application forms, supporting documents, and payment receipts to the relevant authority.
Step 6: Site Inspection
Government officials visit your plot to verify plot size, existing structures, road setbacks, drainage conditions, and neighborhood compliance.
Step 7: Approval Review
The authority formally reviews structural safety, ventilation adequacy, plot coverage, fire safety, parking provision, and environmental compliance.
Step 8: Approval Issuance
Once your application passes review, the approval stamp is issued, your drawings are signed, and construction can legally begin.
How Long Does Building Approval Take in Nigeria?
| Project Type | Estimated Timeline |
|---|---|
| Simple bungalow | 2 to 8 weeks |
| Duplex | 1 to 3 months |
| Commercial building | 3 to 6 months |
| Estate development | Several months or more |
Delays are usually caused by incomplete document submissions, incorrect setbacks, land ownership disputes, structural drawing inconsistencies, outstanding fees, or poor coordination between consultants.
Cost of Building Approval in Nigeria
Approval cost depends on your state, plot size, building size, number of floors, property use, and location value.
| Building Type | Estimated Approval Cost |
|---|---|
| Small bungalow | N200,000 to N800,000 |
| Standard duplex | N500,000 to N2 million |
| Commercial building | N1 million and above |
| Estate development | Several millions |
Premium urban areas in Lagos and Abuja attract higher fees. Always budget for approval costs before starting your project.
Hidden Costs Most Nigerians Ignore
Soil Testing
Poor soil can silently destroy your foundation. Soil testing is especially critical in waterlogged areas of Port Harcourt, Lagos Island, and parts of the Niger Delta region.
Estimated cost: N150,000 to N600,000 depending on location and project size.
Environmental and Drainage Levies
Some states require environmental impact fees, waste management levies, and drainage assessment charges on top of standard approval fees.
Professional Consultant Fees
You will need a registered architect, structural engineer, licensed surveyor, and in many cases a town planner. These are not optional. Professional fees are part of building legally and safely.
Mistakes Nigerians Make During Building Approval
Starting Construction Before Approval Arrives
This is the single most common and costly mistake. Many developers begin fencing, foundation work, or block laying before their approval is issued. The consequences include site sealing, demolition threats, and significant financial loss.
Using Unqualified Designers
Cheap, unregistered designers often produce drawings with wrong setbacks, poor ventilation, unsafe structural layouts, and non-compliant dimensions. These drawings fail during review, wasting time and money.
Ignoring Drainage Planning
Flooding is a real problem in many Nigerian cities. Poor drainage design leads to foundation damage, water stagnation, and shortened property lifespan. Always plan surface drainage, water channels, and rainwater flow from the design stage.
Violating Setback Requirements
Authorities pay close attention to front, rear, and side setbacks. Submitting drawings that push too close to boundaries is one of the fastest ways to delay or lose your approval.
Nigerian Climate, Ventilation, and Building Design Realities
Nigeria’s tropical heat, heavy rainfall seasons, and high humidity directly affect how buildings should be designed and approved.

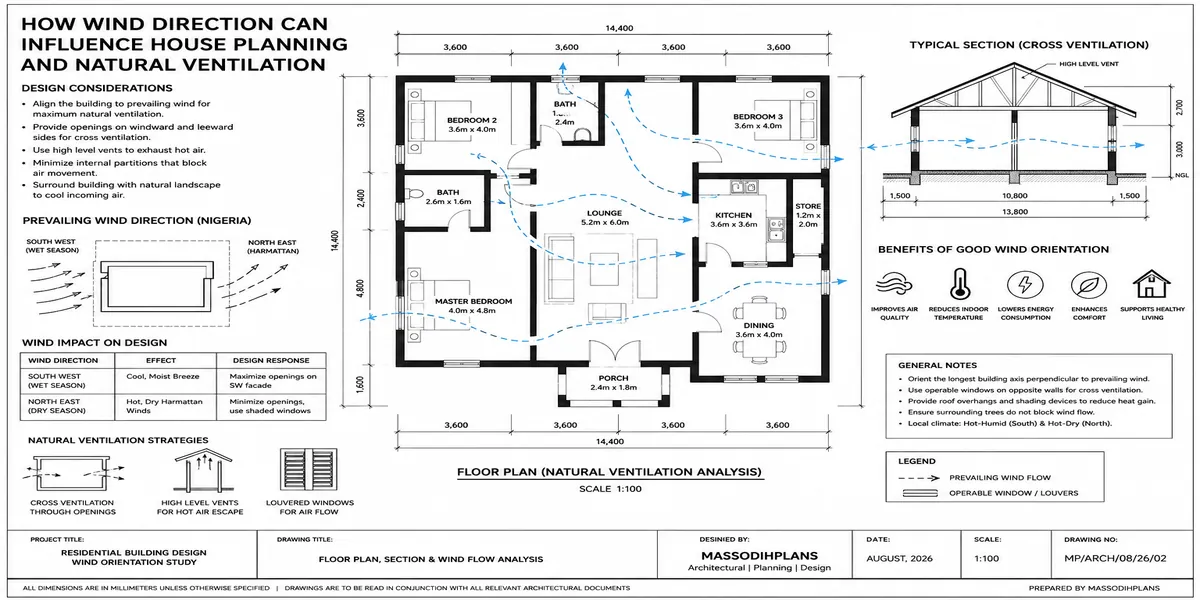

Ventilation requirements: Cross ventilation reduces heat buildup, humidity, and energy consumption. Your bedroom positioning, window arrangement, and corridor planning must support natural airflow.
Heat management: Good design includes wide roof overhangs, heat resistant roofing materials, proper ceiling insulation, and shaded window placement.
Flooding concerns: Flood prone areas require elevated foundations, proper drainage slope, strong concrete mix specifications, and reinforced foundation systems.
These are not optional considerations. They directly affect whether your building performs well and lasts long in Nigerian conditions.
Nigerian Reality Layer: What Most Building Guides Skip
Generator Space Planning
Most Nigerian homes depend on generators. When designing your layout, plan dedicated space for:
- Generator housing with adequate ventilation
- Noise separation from living areas
- Clear exhaust path away from windows
Poor generator placement creates heat problems, noise complaints, and carbon monoxide risks.
Borehole and Water Tank Positioning
Public water supply is unreliable across most Nigerian cities. Plan your compound layout with:
- Clear access for borehole drilling equipment
- Elevated water tank positioning for gravity flow
- Space for pump housing and maintenance access
Compound Security and Gatehouse Positioning
Security planning matters for both daily living and approval compliance. A poorly positioned gatehouse can obstruct drainage channels or road setbacks, creating approval problems.
Practical tips:
- Avoid blind corners that compromise visibility from the main house
- Ensure clear gate sightlines from inside the compound
- Separate pedestrian access from vehicle entry where possible
Lifestyle Planning Inside Your Approval Design
A building design that works for your lifestyle produces a home that serves your family for decades.
Family movement: Children need safe, visible play areas near living spaces. Design corridors and open areas with family flow in mind.
Guest privacy: Plan guest toilet and sitting room positions to keep visitors away from private family areas.
Elderly access: If elderly family members will live with you, avoid split levels and long corridors. Ground floor bedroom access matters.
Work from home: Dedicate a quiet room away from children’s areas for productivity. This is increasingly important for Nigerian professionals.
Future growth: Design with expansion in mind. A building that can accommodate an additional room or floor later protects your investment.
Investment Value of an Approved Building
An approved building consistently outperforms an unapproved one across every financial metric.
- Resale value: Buyers pay more and negotiate less for approved properties
- Rental income: Tenants prefer legally documented buildings
- Bank financing: Mortgages and construction loans require approved plans
- Estate acceptance: Gated communities and estate developers demand compliance
- Long term security: Approved properties face no demolition threat from government
If you are building as an investment, approval is not an expense. It is the foundation of your return.
Practical Ways to Speed Up Your Building Approval
- Hire registered professionals from the start. Architects and engineers registered with their professional bodies produce drawings that pass review faster.
- Submit complete documents in one package. Returning multiple times with missing items causes weeks of delay.
- Follow setback regulations exactly. Do not try to recover every centimeter of land illegally.
- Conduct soil testing early. Discovering soil problems after design submission forces expensive redesigns.
- Maintain a dedicated approval file. Keep every receipt, stamped document, and correspondence organized.
What Builders Usually Get Wrong After Approval
Getting your plan approved is only the beginning. Execution matters just as much.
Poor supervision: Approved drawings can still fail if the construction site is not properly supervised. Visit your site regularly or hire a site supervisor.
Material waste: Poor storage, theft, wrong measurements, and unnecessary rework are expensive. Plan material deliveries in phases.
Structural shortcuts: Some artisans quietly remove reinforcement bars or reduce structural beam sizes to cut costs. This is dangerous and invisible until the building fails. Know what your approved drawings specify and verify it is being built.
Quick Summary
Before construction:
- Verify land documents legally
- Conduct site survey
- Hire qualified professionals
- Prepare complete drawings
During approval:
- Submit all documents together
- Follow setbacks strictly
- Pay all required fees
During construction:
- Supervise work properly
- Avoid structural shortcuts
- Manage drainage carefully
Frequently Asked Questions
How much does building approval cost in Nigeria?
Approval can cost between N200,000 for a small bungalow and several million naira for commercial or estate projects. Costs vary by state, plot size, building height, and location.
Can I build without approval in Nigeria?
Technically yes, but it is illegal in most states and carries serious consequences including fines, stop work orders, demolition notices, and difficulty selling your property later.
How long does building approval take in Nigeria?
Simple residential approvals take 2 to 8 weeks. Larger commercial and estate projects can take 3 to 6 months or more depending on document completeness and state authority workload.
Can my building approval application be rejected?
Yes. Common rejection reasons include wrong setback dimensions, incomplete documents, structural safety concerns, and zoning violations.
Do I need approval for a fence wall in Nigeria?
In many urban areas, yes. Lagos, Abuja, and other major cities require formal approval even for perimeter fencing and gatehouses.
Does building approval increase property value?
Significantly. Approved buildings sell faster, attract higher prices, qualify for mortgages, and are accepted in estates and gated developments.
Related Posts
- Cost of Building a Duplex in Nigeria
- Best House Plans for 450sqm Plots in Nigeria
- Smart Duplex Design for Narrow Plots in Lekki, Nigeria: Complete Practical Guide
- How to Practically Draw and Design a Duplex for Small Plots
- Cost of Roofing a Bungalow and Duplex in Abuja Small Plot Now
- 7 Small Plot Design Mistakes Nigerians Make (And How to Fix Them)
- Modern Bungalow Designs for Small Nigerian Plots
- How to Reduce Building Costs in Nigeria
Call to Action
Planning to build in Nigeria soon?
At MassodihPlans, I help homeowners, investors, and developers with modern house plans, small plot solutions, duplex designs, architectural drawings, site planning, and approval support guidance.
Whether you are building on a compact urban plot or planning a full residential development, proper planning can save you millions in future corrections.
Explore more practical Nigerian building guides on MassodihPlans and start your project the right way.
About Author
Massodih Okon is a built environment professional with a background in architecture and urban planning. He specializes in practical Nigerian house design guidance through MassodihPlans.com.. He has a Master’s degree in Urban and Regional Planning, a first degree in Geography and Environmental Management, and professional certificates in Architectural Design, Landscape Design, and GIS. With over 15 years of hands‑on experience in architecture, town planning, GIS, and building economics across Nigerian residential and institutional projects, he understands the real challenges Nigerians face when planning and building homes.
At MassodihPlans, Massodih shares practical Nigerian building guides, modern bungalow and duplex house plans, and built environment resources created specifically for Nigerian homeowners, developers, and property investors. His work is based on real‑life conditions in Nigeria, climate‑responsive design, and cost‑effective planning, aimed at helping everyday Nigerians make smarter, more confident building decisions.
Reference
